Lam Trans Project Timeline

In November 2023, Electrical Technology management proposed to the Weidmann board to build a new Lam board factory in Croatia. The current Lam board production site in Ennenda needs to be vacated latest by the end of June 2025, therefore existing equipment must be transferred to Croatia and for this purpose Project LamTrans was initiated.

In Pojatno near Zagreb, close to the existing Weidmann facilities, a land plot of total 22’000 m2 was acquired to accommodate the new factory on a green field.

February 2024
During February and March 2024, the building concept was developed together with production and logistics experts. On March 18th the steering committee decides for building version of total 7200m2 surface. The planning contains production, warehouse and offices.
July 2024
Preproduction of additional 1,500 tons LamBord started July 24 to cover planned customer demand during the transition phase. Preproduction is packed in double layer packaging and stored in defined locations.
July 2024
Architects main design was finished July 24 and project was submitted to local authorities for building permit. The building is designed to meet state of the art levels of sustainable energy management and environmental protection.
October 2024
Construction on site started with ground preparing works. Beginning of October we obtained official building permit and started to erect the building. Construction makes fast progress as it mainly contains prefabricated elements.
March 2025
Completion of Know-How Transfer from Ennenda to Pojatno

More information coming soon.

March 2025
Completion of Pre-Production at Ennenda Site

More information coming soon.

May 2025
Equipment Disassembled and Prepared for Transport

More information coming soon.

May 2025
Building Release at Pojatno Site

More information coming soon.

June 2025
Equipment Ready for Production Start-Up at Pojatno

More information coming soon.

June 2025
Building Closure at Ennenda Site

More information coming soon.

July 2025
Internal Release for Production at Pojatno Site

More information coming soon.

August 2025
Completion of Customer Audits at Pojatno Site

More information coming soon.

September 2025
Customer Approval Granted for Pojatno Site

More information coming soon.

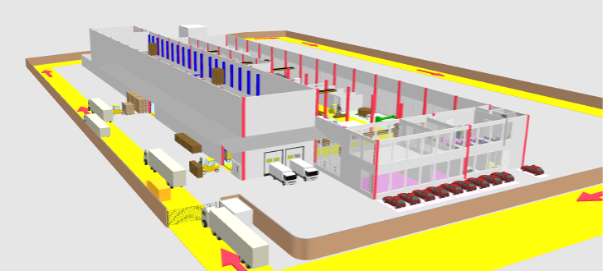

The building concept for the Pojatno site, including the layout for Production and Logistics, has been completed

During February and March 2024, the building concept was developed together with production and logistics experts. On March 18th the steering committee decides for building version of total 7200m2 surface. The planning contains production, warehouse and offices.

The building concept for the Pojatno site, including the layout for Production and Logistics, has been completed

Preproduction of additional 1’500 tons LamBord started July 24 to cover planned customer demand during the transition phase. Preproduction is packed in double layer packaging and stored in defined locations.

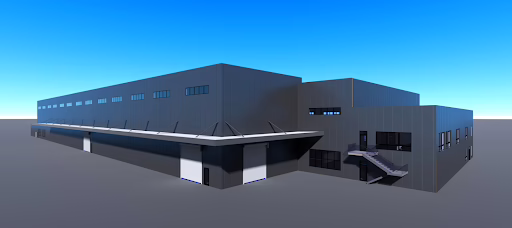

Building submission issue to authorities

Architects main design was finished July 24 and project was submitted to local authorities for building permit. The building is designed to meet state of the art levels of sustainable energy management and environmental protection.

Start building construction

Construction on site started with ground preparing works. Beginning of October we obtained official building permit and started to erect the building. Construction makes fast progress as it mainly contains prefabricated elements.
